Little Havana Pedestrian Priority Zone - Phase I

In 2021, City of Miami District 3 Commissioner Joe Carollo committed $2.5 million for the improvement, along with a $3M bipartisan bill sponsored by Senator Ileana Garcia and House Representative Michael Greico that passed in June 2021. In May 2022, the City of Miami Office of Capital Improvements developed the project scope and budget estimates to construct pedestrian safety improvements and have begun project design for priority one projects.

The City of Miami, in partnership with the State of Florida, is designing a plan to provide pedestrian safety in Little Havana in District 3.  The project will include various elements to improve the quality of life and provide pedestrian safety for school children, students and everyone in the community.

Project Number: 40-B213602

Little Havana Pedestrian Priority Zone - Phase I - May 15, 2025, Community Presentation

Little Havana Pedestrian Priority Zone - Phase I Presentation (cover page)

Little Havana Pedestrian Priority Zone - Phase I Presentation (project objectives)

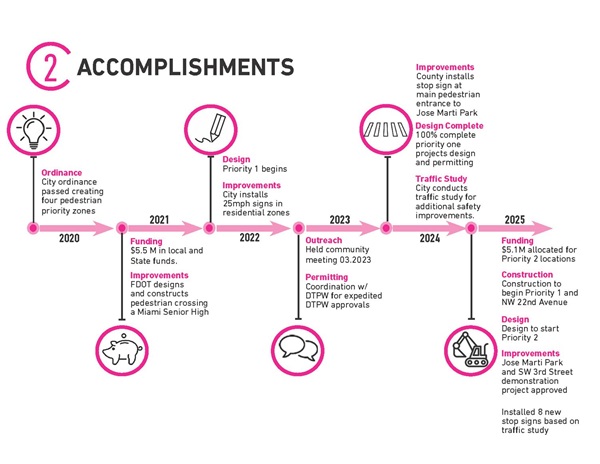

Little Havana Pedestrian Priority Zone - Phase I Presentation (accomplishments)

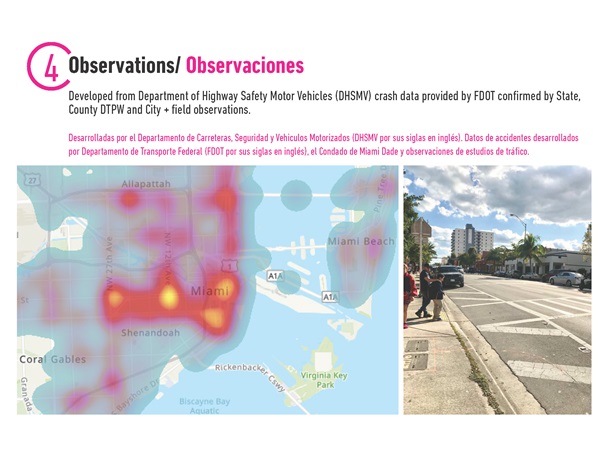

Little Havana Pedestrian Priority Zone - Phase I Presentation (observations)

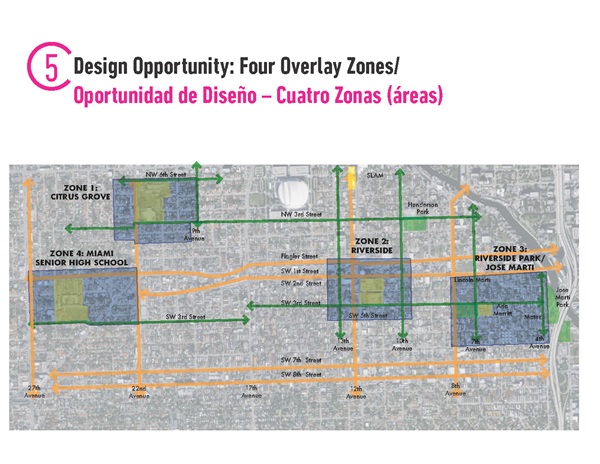

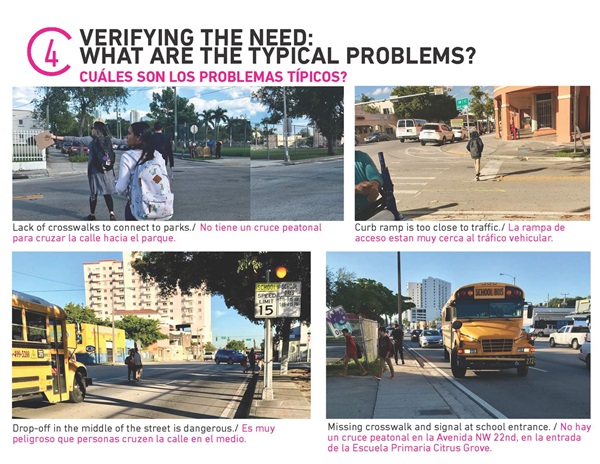

Little Havana Pedestrian Priority Zone - Phase I Presentation (verifying the needs: what are the typical problems?)

Little Havana Pedestrian Priority Zone - Phase I Presentation (design solutions)

Little Havana Pedestrian Priority Zone - Phase I Presentation (greenways)

Little Havana Pedestrian Priority Zone - Phase I Presentation (pedestrian signals and no right on red)

Little Havana Pedestrian Priority Zone - Phase I Presentation (midblock crossings)

Little Havana Pedestrian Priority Zone - Phase I Presentation (planned projects)

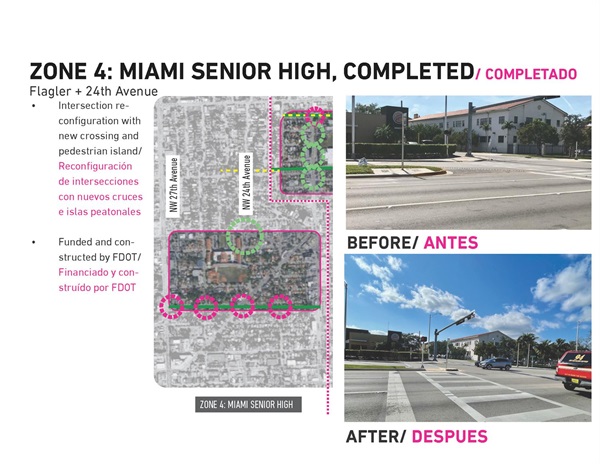

Little Havana Pedestrian Priority Zone - Phase I Presentation (Miami Senior High, completed)

Little Havana Pedestrian Priority Zone - Phase I Presentation (Jose Marti Park connection, completed)

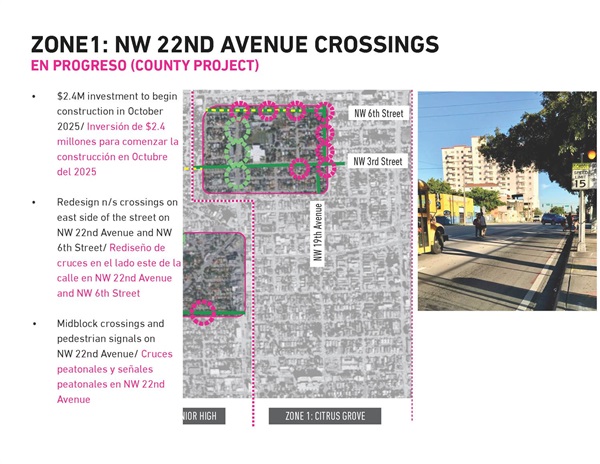

Little Havana Pedestrian Priority Zone - Phase I Presentation (NW 22nd avenue crossings)

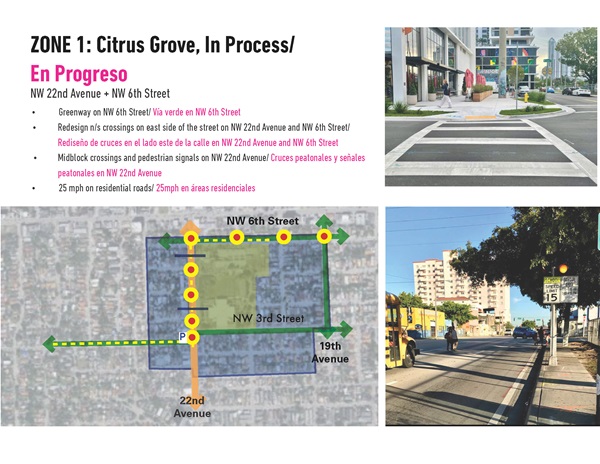

Little Havana Pedestrian Priority Zone - Phase I Presentation (zone 1: NW 6th street greenway)

Little Havana Pedestrian Priority Zone - Phase I Presentation (NW 6th street greenway the numbers)

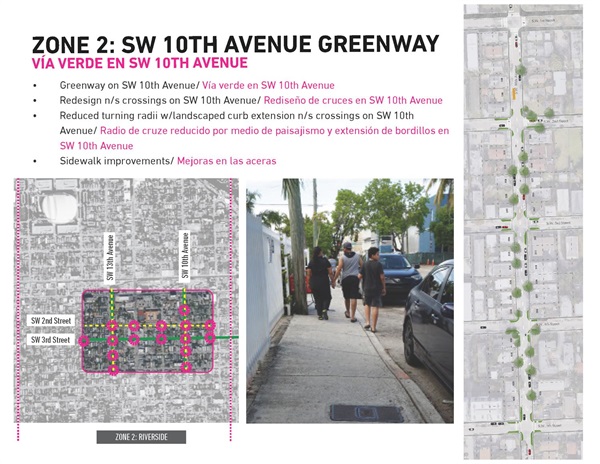

Little Havana Pedestrian Priority Zone - Phase I Presentation (zone 2: SW 10th avenue greenway)

Little Havana Pedestrian Priority Zone - Phase I Presentation (SW 10th avenue greenway the numbers)

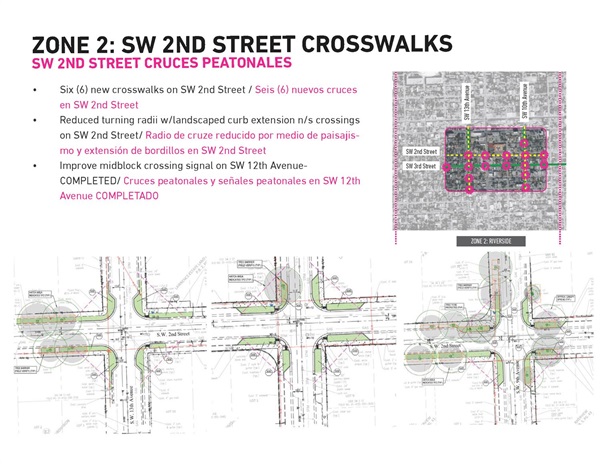

Little Havana Pedestrian Priority Zone - Phase I Presentation (zone 2: SW 2nd street crosswalks)

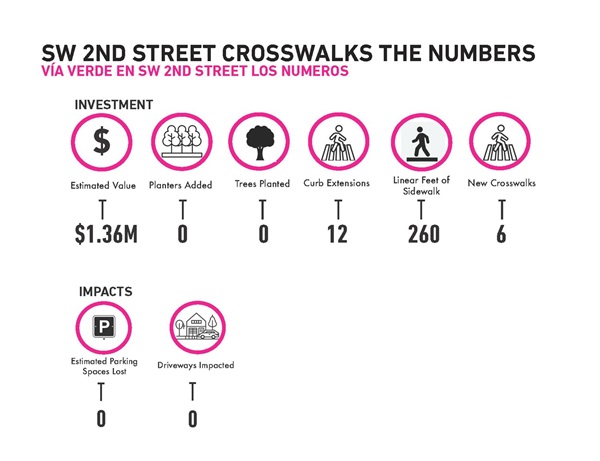

Little Havana Pedestrian Priority Zone - Phase I Presentation (SW 2nd street crosswalks the numbers)

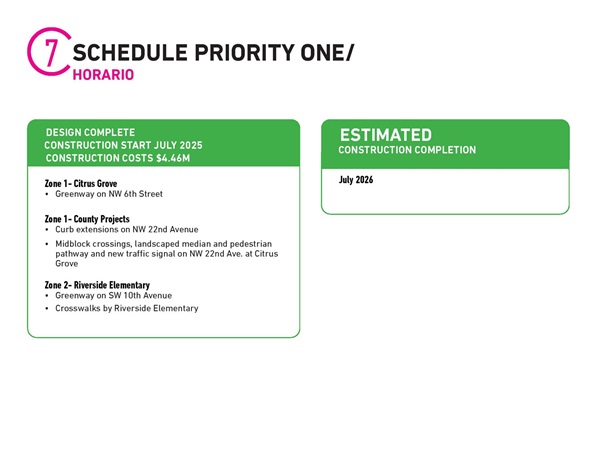

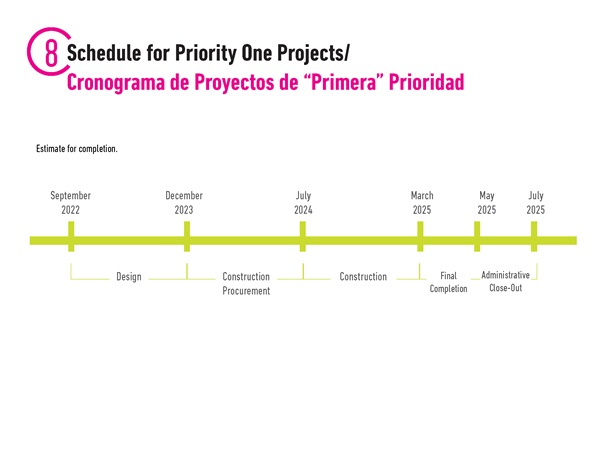

Little Havana Pedestrian Priority Zone - Phase I Presentation (schedule priority one)

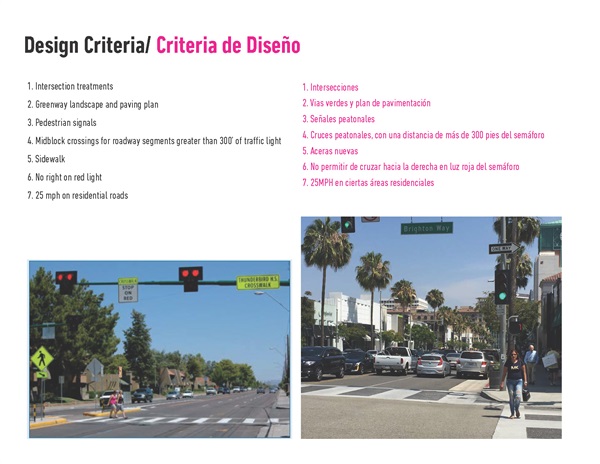

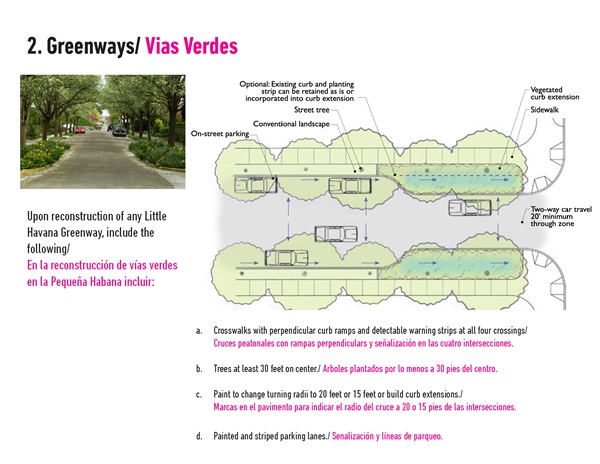

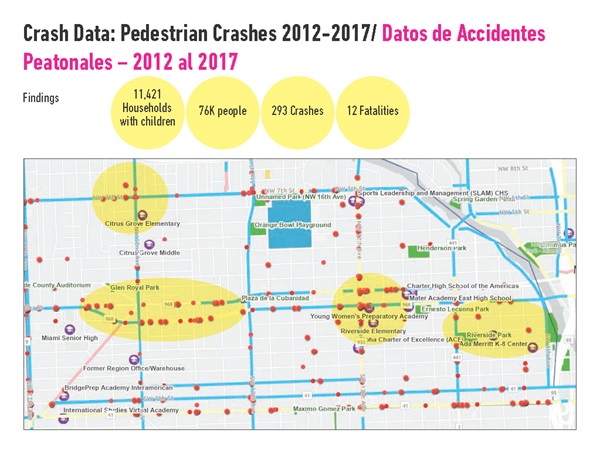

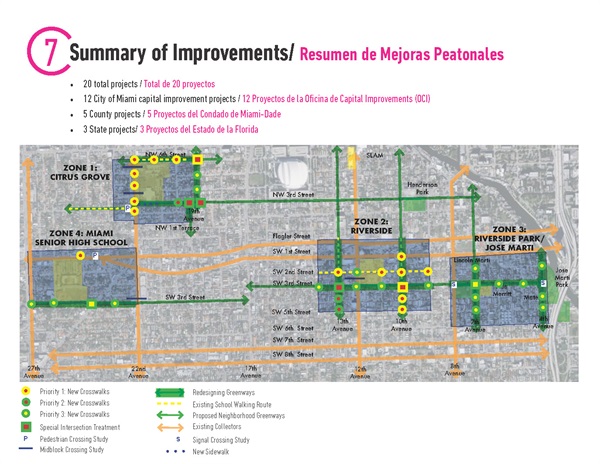

Little Havana Pedestrian Priority Zone - Phase I - Feb 15, 2023, Community Presentation

Current Project Status:

Construction.

Project Scope:

Design and construction of pedestrian safety and greenway improvements and associated right-of-way improvements including sidewalks, ADA ramps, pedestrian crosswalks, planter islands, landscaping, lighting, milling and resurfacing, pavement markings, and related drainage relocations.

Project Cost Estimate:

$5,504,338

Project Benefits and Impacts:

  • Number of properties impacted: Total = 330 (171 Residential and 159 Non-Residential)
  • Total property value protected: $254M

Project Boundaries:

Zone 1 - NW 6 Street between NW 22 Avenue (excluding crossings) and NW 19 Avenue.

Zone 2 - SW 10 Avenue between W Flagler Street (excluding Flagler Street, SW 1 Street intersections) and SW 5 Street. Intersections of: SW 2 Street and SW 9 Avenue, SW 2 Street and SW 11 Avenue, SW 2 Street and SW 13 Avenue.

Map illustrating the project boundaries of 40-B213602 (NW 6 ST)

Map illustrating the project boundaries of 40-B213602 (SW 10 AV and intersections)

Road Closures:

Some road closures may occur during construction but will be sequenced appropriately to minimize disruption to the residents.

Estimated Construction Timeline:

Subject to change.

  • Estimated Construction Start: Summer 2025
  • Estimated Construction End: Summer 2026
