Silver Bluff Traffic Flow Modification

Project Number: 40-B243604
Current Project Status (October 2025):
Planning, Design and Construction.
Update December 2025: Group 5 under construction.
Project Scope:
Traffic study for traffic calming, safety improvements and movement restrictions. Assessment of twenty-six locations for traffic calming device installations; balloting of applicable locations; design and construction of traffic calming devices at eligible locations.
Project Cost Estimate:
$7,848,323

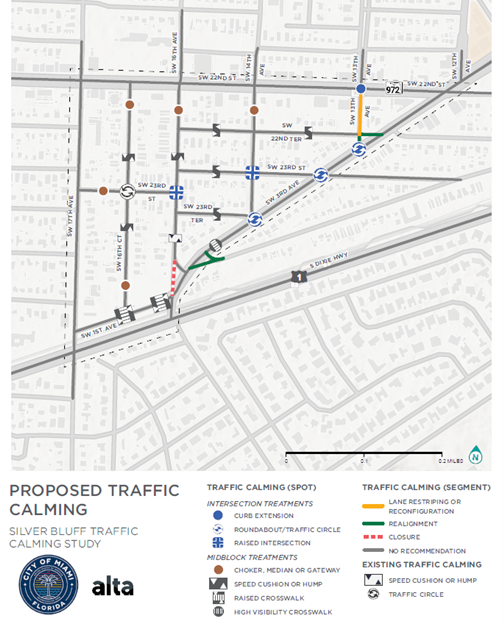

Project Boundaries:
The project limits are bounded by Coral Way, SW 1 AV, SW 17 AV and SW 3 AV.

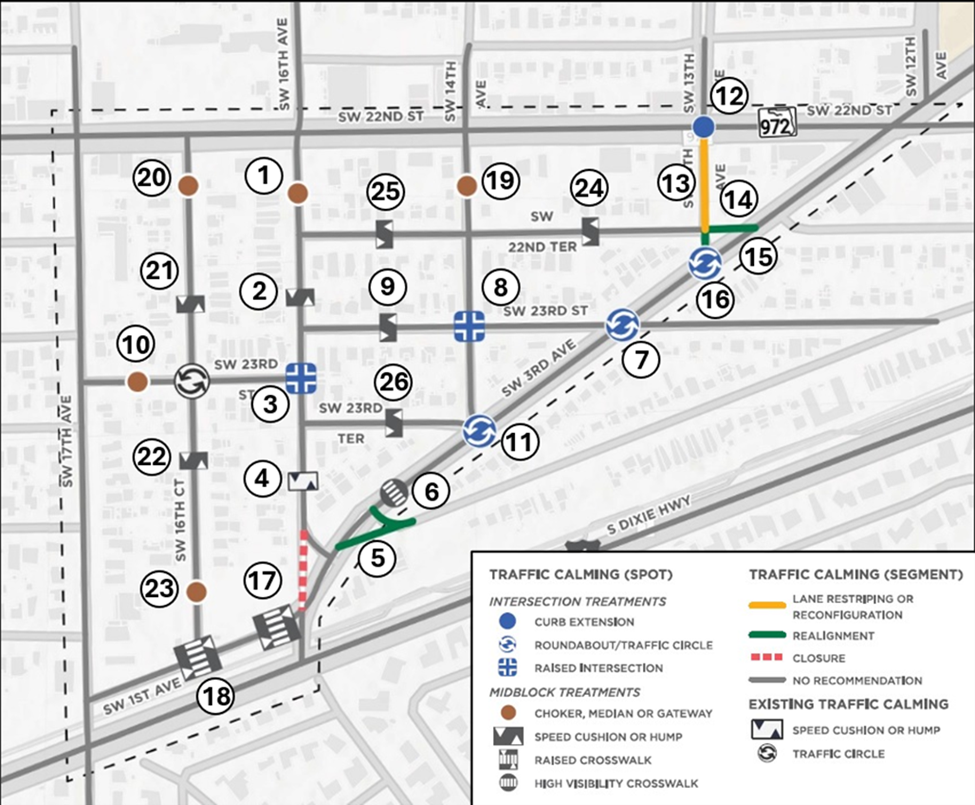

Group 1 - In Design
#1. SW 16 Ave between SW 22 ST and SW 22 Ter (Choker)
#2. SW 16 Ave between SW 22 Ter and SW 23 St (Speed Hump)
#3. SW 16 Ave and SW 23 St (Raised Intersection)
#5. SW 1 Ave and SW 3 Ave (Realignment)
#6. SW 3 Ave between SW 14 Ave and SW 16 Ave (High Visibility Crosswalk)
#7. SW 23 St and SW 3 Ave (Roundabout)
Group 2 - Under Construction
#9. SW 23 St between SW 14 Ave and SW 16 Ave (Speed Cushion)
#24. SW 22 Ter between SW 13 Ave and SW 14 Ave (Speed Cushion)
#26. SW 23 Ter between SW 14 Ave and SW 16 Ave (Speed Cushion)
Group 3 - In Design
#4. SW 16 Ave between SW 1 Ave and SW 23 Ter (Street Closure)
#17. SW 1 Ave between SW 16 Ave and SW 16 Ct (Raised Crosswalk)
#18. SW 1 Ave between SW 16 Ct and SW 17 Ave (Raised Crosswalk)
Group 4 - In Design
#10. SW 23 St between SW 16 Ct and SW 17 Ave (Choker)
#19. SW 14 Ave between SW 22 St and SW 22 Ter (Choker)
#20. SW 16 Ct between SW 22 St and SW 23 St (Choker)
#23. SW 16 Ct between SW 23 St and SW 1 Ave (Choker)
Group 5 - Under Construction
#21. SW 16 Ct between SW 22 St and SW 23 St (Speed Cushion)
#22. SW 16 Ct between SW 23 St and SW 1 Ave (Speed Cushion)
#25. SW 22 Ter between SW 14 Ave and SW 16 Ave (Speed Hump)
Group 6 - Planning
#8. SW 14 Ave and SW 23 St (Raised Intersection)
#11. SW 14 Ave and SW 3 Ave (Roundabout)
#12. SW 22 St and SW 13 Ave (Curb Extension)
#13. SW 13 Avenue between SW 22 St and SW 22 Ter (Restriping/ Reconfiguration)
#14. SW 22 Ter between SW 3 Ave and SW 13 Ave (Realignment)
#15. SW 13 Ave between SW 22 Ter and SW 3 Ave (Realignment)
#16. SW 13 Ave and SW 3 Ave (Roundabout)

Road Closures:
Some road closures may occur during construction but will be sequenced appropriately to minimize disruption to the residents.
Estimated Construction Timeline:
Subject to change.
- Estimated Construction Start: September 2025
- Estimated Construction End: Summer 2027
